See a sample final audit, before you upload yours.
This is what comes back from a scoped drawing audit: the marked sheet, the finding, the sheet references, and the reason it matters before bid or issue.
Results may be held if drawing quality isn’t audit-ready. We don’t promise every upload gets a full pack.
What’s in the pack
- Bluebeam-ready marked PDF
- One-page forensic summary with sheet references and finding context
- Excel/CSV companion for forwarding findings to Precon, VDC, or the project team
The marked sheet and shortened issue log on this page are the sample.
Sample report

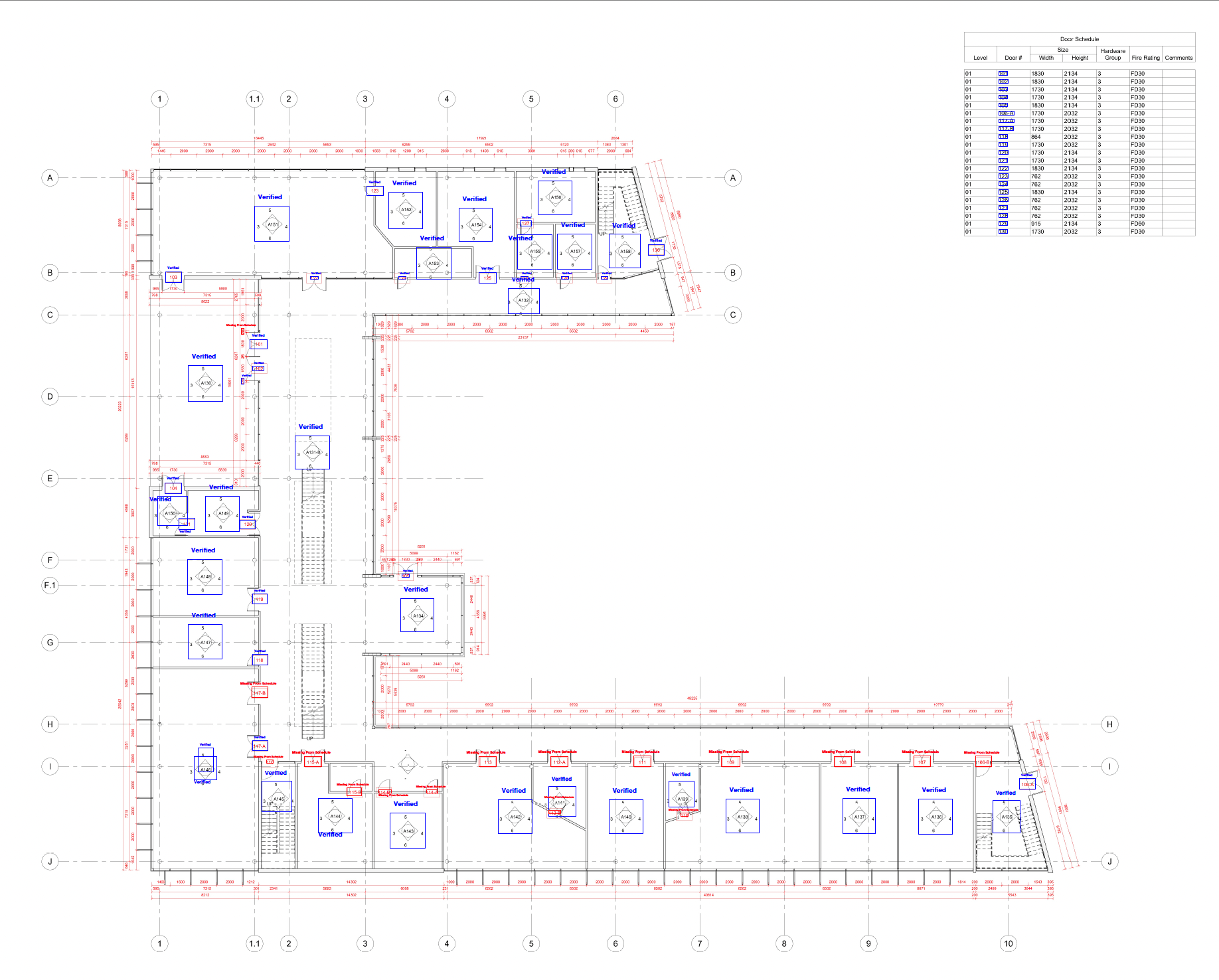

Bluebeam-ready findings on the plan: verified marks, missing-from-schedule and wrong-door-material callouts, and the door schedule.

Download sample issue log (Excel)
- Sheet index gap: a sheet is listed in the index but missing from the set.
- Dead callout: a callout points to a detail that is not present or does not resolve.
- Door schedule mismatch: the door tag, schedule entry, and plan opening do not agree.
Sample issue log
A shortened companion to the marked sheet: the issue, the sheet, the description, and an estimated rework/risk for review.
Download sample issue log (Excel)
Incorrect Reference Detail
Issue SBI-0001
Sheet A101 · Page 1
Callout symbol references a detail that does not exist.
Estimated rework/risk: $2,000
Missing Sheets
Issue SBI-0002
Sheet A101 · Page 1
Sheet A102 is listed in the sheet index but is not included in the set.
Estimated rework/risk: $500
Missing From Schedule
Issue SBI-0003
Sheet A101 · Page 1
Door tag 104 is shown on the plan and has no matching door-schedule row.
Estimated rework/risk: $5,000
Missing From Schedule
Issue SBI-0004
Sheet A130 · Page 4
Door tag 118 on the plan does not appear in the door schedule.
Estimated rework/risk: $5,000
Incorrect Reference Detail
Issue SBI-0012
Sheet A131 · Page 5
Callout symbol references a detail that does not exist.
Estimated rework/risk: $2,000
Missing From Schedule
Issue SBI-0005
Sheet A131 · Page 5
Door tag 203 is tagged on the plan but missing from the door schedule.
Estimated rework/risk: $5,000
Schedule Mismatch
Issue SBI-0006
Sheet A132 · Page 7
Door tag 210 on the plan does not match the width listed in the door schedule.
Estimated rework/risk: $5,000
Missing From Schedule
Issue SBI-0007
Sheet A135 · Page 9
Door tag 221 is on the plan opening and is absent from the door schedule.
Estimated rework/risk: $5,000
Schedule Mismatch
Issue SBI-0008
Sheet A140 · Page 14
Door tag 305 hardware group on the plan does not match the door schedule.
Estimated rework/risk: $5,000
Missing From Schedule
Issue SBI-0009
Sheet A147 · Page 21
Door tag 412 is shown at the corridor and is not on the door schedule.
Estimated rework/risk: $5,000
Schedule Mismatch
Issue SBI-0010
Sheet A151 · Page 25
Door tag 418 fire rating on the plan does not agree with the door schedule.
Estimated rework/risk: $5,000
Missing From Schedule
Issue SBI-0011
Sheet A102 · Page 2
Door tag 109 is on the plan and missing from the door schedule.
Estimated rework/risk: $5,000
Estimated rework/risk is illustrative marketing framing for typical field/RFI exposure, not a quote or guarantee.
How to read the markups in Bluebeam
Open the marked PDF in Bluebeam, follow the cloud and sheet reference, and resolve the finding in the drawing workflow your team already runs. MarkedUp flags the relationship; your project team remains responsible for the design decision.
ConstructionProof is the drag-and-drop path. It is not a separate drawing system.
